Base Solution Interface Documentation

The base solution provides all the necessary definitions and information, such as:

Where can I find the Base Solution Interface file?

C:\Program Files\FACTON\FACTON EPC Solution Development Environment\PlatformSolutions



How can I exchange the base solution?

  1. Select the cost model " TableModel" in "My Local Configuration".

    The Item Details view opens below.

    Here you will see the Base Solution Name and Base Solution Version.

  2. Click on [...] next to the base solution name to select a different version.

  3. Navigate to "C:\Program Files\FACTON\FACTON EPC Solution Development Environment\PlatformSolutions".

  4. Select the base solution.

    The base solution version changes according to the selected file.



Hint

Base Solution properties can be recognized by gray symbols ( ).

  • Base Solution Name

    Shows the name of the base solution on which the respective cost model is based. For the "TableModel" cost model it is the "Facton.Solutions.Samples.Base.Core" which was installed with the FACTON CMD.

    Note

    The file name ("Facton.Solutions.Samples.Base.Core.22.1.XXXXX.costModelInterface") is a concatenation of the actual name of the solution and its version.

  • Base Solution Version

    Shows the version number of the base solution. This can be the exact version (as in the package file name, see above). It is possible to define version ranges using the NuGet syntax (versioning notations for intervals).

    Example

    [1.0,2.0), which means 1.0 ≤ x < 2.0.

    Further Information see Version ranges.



Basic Concept – Cost Calculation

The following resources are available under a "Project" calculation:

  • Product
  • Assembly
  • Material
  • Part
  • Process

Some resources have interface properties which can be overridden by a cost model. To determine the Costs in the Base Solution the following formula is used across the board:

Provides ProductionCost [Money, Structural] =

DirectMaterialCost + DirectManufacturingCost;

The DirectMaterialCost will be determined at the "Material" resource using its "Volume" where as the DirectManufacturingCost depends on the "Cycle Time" of the "Process".



Resource Structure /  Resource Allocation

The resources can be allocated in the following way under a "Project" calculation:



Resource Interface Properties

The Base Solution provides some interface properties which can be set by a cost model.

Target Resource Domain Type Interface Property Domain Type
Product Piece ManufacturingCostRate Money/Time
Assembly Piece RelevantQuantity ResourceQuantityType
Material Volume ShapeVolume Volume
MaterialShapeExtensionPoint ExtensionOf(MaterialShapeExtensionType)
MaterialClassification TMaterialClassification
Part Piece RelevantQuantity ResourceQuantityType
Process Cycle ExtProcessCycleTime Time/ResourceQuantityType

Calculating Shape Specific Material Volume

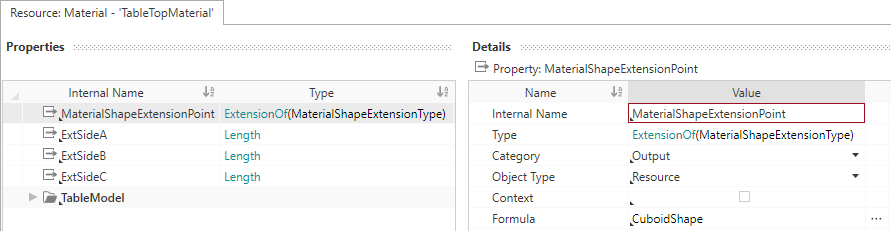

If you want to calculate the material volume based on a predefined shape you can do this if you set the corresponding extension for the "MaterialShapeExtensionPoint" property at the "Material:

Shape Material Shape Extension Interface Property Domain Type
Cube CubeShape ExtSideLength Length
Cuboid CuboidShape ExtSideA Length
    ExtSideB Length
    ExtSideC Length
Pyramid PyramidShape ExtSideCount Integer
    ExtHeight Length
    ExtSideLength Length
Sphere SphereShape ExtRadius Length



Extension points of "Details" view

Each resource provides a "Details" view extension point for easy cost model integration. The detail view extension points follow a simple naming scheme:

"CostModel-[Resource]-[Target ViewSchema]"

Note

Currently there is only the “Default” view schema supported.



Example

To add new properties to the "Material" detail view simply reference it as follows:

CostModel-Material-Default

More extension point names for the "Details" view for each available resource in the base solution.

Target Resource Detail View Extension Name
Product CostModel-Product-Default
Assembly CostModel-Assembly-Default
Material CostModel-Material-Default
Part CostModel-Part-Default
Process CostModel-Process-Default
